Timeframe for connection of supply

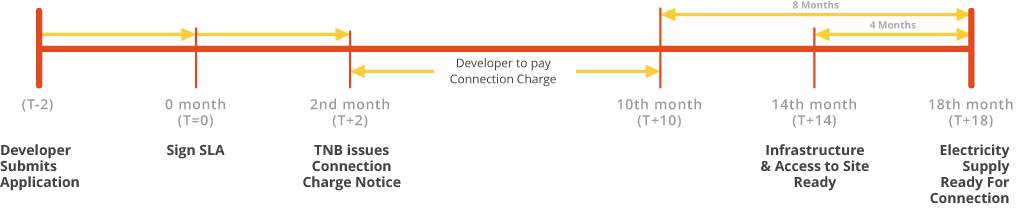

Typical timeframe for connection of supply within 18 months

Note: T = Date SLA Signed

Roles and responsibilities

Developer should

1Submit complete application form with the relevant documents required by TNB.

2Sign SLA with TNB (if all documents are in order).

3Pay connection charges upon notification from TNB within agreed timeframe.

4Build substation and complete it within 4 months prior to connection of electricity supply.

TNB should

1Sign SLA with developer.

2Issue Notice of Connection Charges within 2 months after SLA agreement is signed.

3Commence works no later than 4 months prior to connection of electricity supply.

COST
RM10 Stamp duty

Penalty clause

Compensation to be paid by both parties if they fail to fulfill their respective obligations as stated in the SLA.
